Page 75 - Damen Shipyards Group
P. 75

74  REPAIR & CONVERSION | DESTINATION OF CHOICE                                                                         75





































 DESTINATION



 OF CHOICE







 FO R T H E M OS T CO M PL E X   S O M U C H W O R K , S O L I T T L E T I M E  O N T I M E A N D F I T- F O R - P U R P OS E

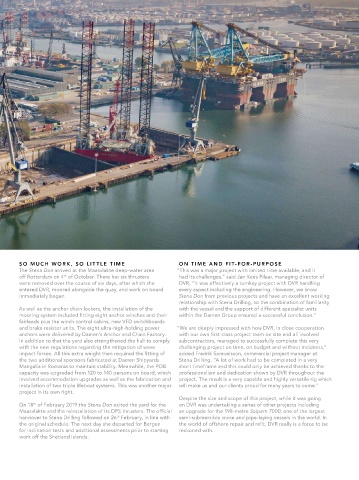

 O FFS H O R E PR O JEC T S  The Stena Don arrived at the Maasvlakte deep-water area   “This was a major project with limited time available, and it
                        th
                                                                 had its challenges.” said Jan Kees Pilaar, managing director of
        off Rotterdam on 4  of October. There her six thrusters
        were removed over the course of six days, after which she   DVR, “It was effectively a turnkey project with DVR handling
        entered DVR, moored alongside the quay, and work on board   every aspect including the engineering. However, we know
        immediately began.                                       Stena Don from previous projects and have an excellent working
 DA M E N V E R O L M E R OT T E R DA M ( DV R ) I S FA S T A PPR OAC H I N G I T S S E CO N D   relationship with Stena Drilling, so the combination of familiarity
 A N N I V E R SA R Y O F J O I N I N G T H E DA M E N FA M I LY. I N T H AT S H O R T S PAC E O F T I M E I T   As well as the anchor chain lockers, the installation of the   with the vessel and the support of different specialist units
        mooring system included fitting eight anchor winches and their   within the Damen Group ensured a successful conclusion.”
 H A S A L R E A DY D E M O NS T R AT E D I T S A B I L I T Y TO TA K E O N T H E L A R G E S T A N D M O S T   fairleads plus the winch control cabins, new VFD switchboards
 CO M PL E X O F F S H O R E PR O J E C T S T H A N K S B OT H TO I T S I M PR E SS I V E FAC I L I T I E S A N D   and brake resistor units. The eight ultra-high-holding power   “We are deeply impressed with how DVR, in close cooperation
        anchors were delivered by Damen’s Anchor and Chain Factory.   with our own first-class project team on site and all involved
 I T S M O R E T H A N 6 0 Y E A R S O F S H I P R E PA I R A N D CO N V E R S I O N E X PE R I E N C E .  In addition to that the yard also strengthened the hull to comply   subcontractors, managed to successfully complete this very
        with the new regulations regarding the mitigation of wave   challenging project on time, on budget and without incidents,”
        impact forces. All this extra weight then required the fitting of   added Fredrik Samuelsson, commercial project manager at
 S T E N A D O N  The refit process in fact started more than three months earlier   the two additional sponsons fabricated at Damen Shipyards   Stena Drilling. “A lot of work had to be completed in a very
 If further proof was needed as to its capabilities, then the recent   at the signing of the contract. Work got immediately underway   Mangalia in Romania to maintain stability. Meanwhile, the POB   short timeframe and this could only be achieved thanks to the
 major refit of the drilling rig Stena Don is surely it. The vessel   on preparations for the installation of the new, eight-point   capacity was upgraded from 120 to 140 persons on board, which   professionalism and dedication shown by DVR throughout the
 arrived in Rotterdam on the 4  of October 2018 and remained   mooring system that was to be the largest single element of the   involved accommodation upgrades as well as the fabrication and   project. The result is a very capable and highly versatile rig which
 th
 there for nearly five months undergoing a comprehensive range   refit. Engineering began at once followed by the manufacture   installation of two triple lifeboat systems. This was another major   will make us and our clients proud for many years to come.”
 of works to prepare her for her next project, with DVR delivering   of various elements of the system including the anchor chain   project in its own right.
 a complete turnkey package.  lockers, and also two sponsons. Weighing 1,200 tonnes in total,   Despite the size and scope of this project, while it was going
 they were all fabricated at Damen Shipyards Mangalia before   On 18  of February 2019 the Stena Don exited the yard for the   on DVR was undertaking a series of other projects including
             th
 The Stena Don, a harsh environment, dynamically positioned, fifth    being shipped to Rotterdam ready for installation.  Maasvlakte and the reinstallation of its DPS thrusters. The official   an upgrade for the 198-metre Saipem 7000, one of the largest
 generation semi-submersible drilling rig capable of drilling in   handover to Stena Drilling followed on 26  February, in line with   semi-submersible crane and pipe-laying vessels in the world. In
                                          th
 waters up to 650 metres deep, is owned and operated by Stena   The installation of an eight-point mooring system was deemed   the original schedule. The next day she departed for Bergen   the world of offshore repair and refit, DVR really is a force to be
 Drilling. 95.5 metres in length and with a beam of 67 metres, she   necessary for her future drilling contracts. The Stena Don already   for inclination tests and additional assessments prior to starting   reckoned with.
 was built by the Kvaerner Warnow Werft Shipyard in Germany in   had a DP3 system for maintaining position, but an anchor-based   work off the Shetland Islands.
 2001 and, following the refit, has accommodation for up to 140   system is more effective in shallow waters and, by not having
 personnel.   thrusters in continual operation, emissions can be significantly
 reduced and substantial savings on fuel costs made.
